Roseworthy / Cornwall / Case study

Planning permission secured /

Roseworthy
recycling facility.

Planning permission secured for a new recycling facility in Cornwall. One application. One coordinated team.

Roseworthy / Operational planCE-1001 / P11

Detail of Atkins proposed site plan for the Roseworthy Compost Facility, showing the processing yard, building, attenuation pond, access and landscape earthworks.
View complete application drawing
  1. 01Processing yard
  2. 02Building & office
  3. 03Attenuation pond
Actual project drawing / Atkins / Proposed Site Plan P11, November 2024
Waste, Landfill & Environmental

Real STAGE project / Planning permission granted 19 December 2025. Application drawings shown.

Client
The Green Waste Company
Location / Reference
Roseworthy / Cornwall
PA24/08685
STAGE role
Application lead, whole-project management and consultant coordination
Planning outcome
Permission granted 19 December 2025
Approximate application site
5.9 haTwo adjoining agricultural fields
Proposed material streams
3Green waste / wood / agricultural plastics
Supporting items scheduled
27Drawings, reports and community engagement
  1. 01 / Material stream

    Green waste

    Open-windrow composting

  2. 02 / Material stream

    Waste wood

    Separate processing and recycling

  3. 03 / Material stream

    Agricultural plastics

    Reception, baling and onward transfer

The asset / Opportunity

An operational opportunity, grounded in the site.

The Green Waste Company identified land south of the A30 and north of Roseworthy Hill, near Connor Downs in Cornwall, for a new wood, composting and green-waste processing and recycling facility.

The approximately 5.9-hectare holding comprised two agricultural fields. Its location offered an opportunity to reorganise the operator’s collection network, but the sloping land and rural setting meant the operational brief and the site’s constraints had to develop together.

The client objective

Make the facility work for the business and the setting.

The client sought a practical facility for open-windrow composting, separate waste-wood processing, and the reception, baling and onward transfer of agricultural plastics. The brief also included a workshop and storage building, office, weighbridge, access, parking and water-management infrastructure.

The planning case connected that operational brief with the site-selection rationale and collection network. The proposed location was intended to reduce unnecessary transport between collection sources and the existing operation.

The challenge

The operating yard was only part of the planning question.

A large working platform on sloping agricultural land brought earthworks, retaining structures and new impermeable surfaces into the design. Drainage, process-water management, HGV movements and the relationship between the building and the yard could not be resolved as separate exercises.

Landscape and visual effects, neighbouring uses, ecology, Cornish hedges, trees, heritage, archaeology, noise, dust and air quality also required evidence. The task was to bring the findings into a coherent proposal while retaining the operating requirements that made the facility viable.

What was at risk

The commercial position behind the planning question.

  • An unworkable layout

    A scheme that addressed one constraint in isolation could undermine vehicle circulation, processing space, drainage or the wider site arrangement.

  • Late technical change

    Landform, surface-water and environmental requirements needed to inform the design before the planning case and drawings moved apart.

  • An incomplete planning case

    The operational need and intended benefits had to be assessed alongside local effects, mitigation and the supporting specialist work.

The STAGE strategy

Intelligence.
A coordinated route.

Planning leads the strategy. Design, site intelligence and specialist evidence develop together around the asset and the client’s decision.

  1. Start with the operation

    Set out the material streams, processing sequence, collection network and site-selection rationale. Connect the proposed facility with the client’s existing business.

  2. Let the site shape the layout

    Place the building into the south-western slope, orientate its active face north, and use retaining structures, embankments and planting to help contain views of the working yard.

  3. Bring the evidence together

    Connect the engineering and drainage proposals with landscape, ecology, heritage, amenity and transport reporting. Explain their relationship in the Planning, Design and Access Statement.

  4. Make the planning case

    Assess the proposal against the relevant planning framework, explain the operational need and describe the mitigation and enhancement measures proposed by the specialist team.

The technical record

One site. Every detail connected.

The operating yard, landform and drainage had to work as one proposal. Explore the actual engineering drawings behind the planning case, from the site boundary to the pond sections.

The drawing record 05 sheets

  1. View original sheet
  2. View original sheet
  3. View original sheet
  4. View original sheet
  5. View original sheet

Select a drawing to explore the proposal. Every original sheet remains available at full resolution.

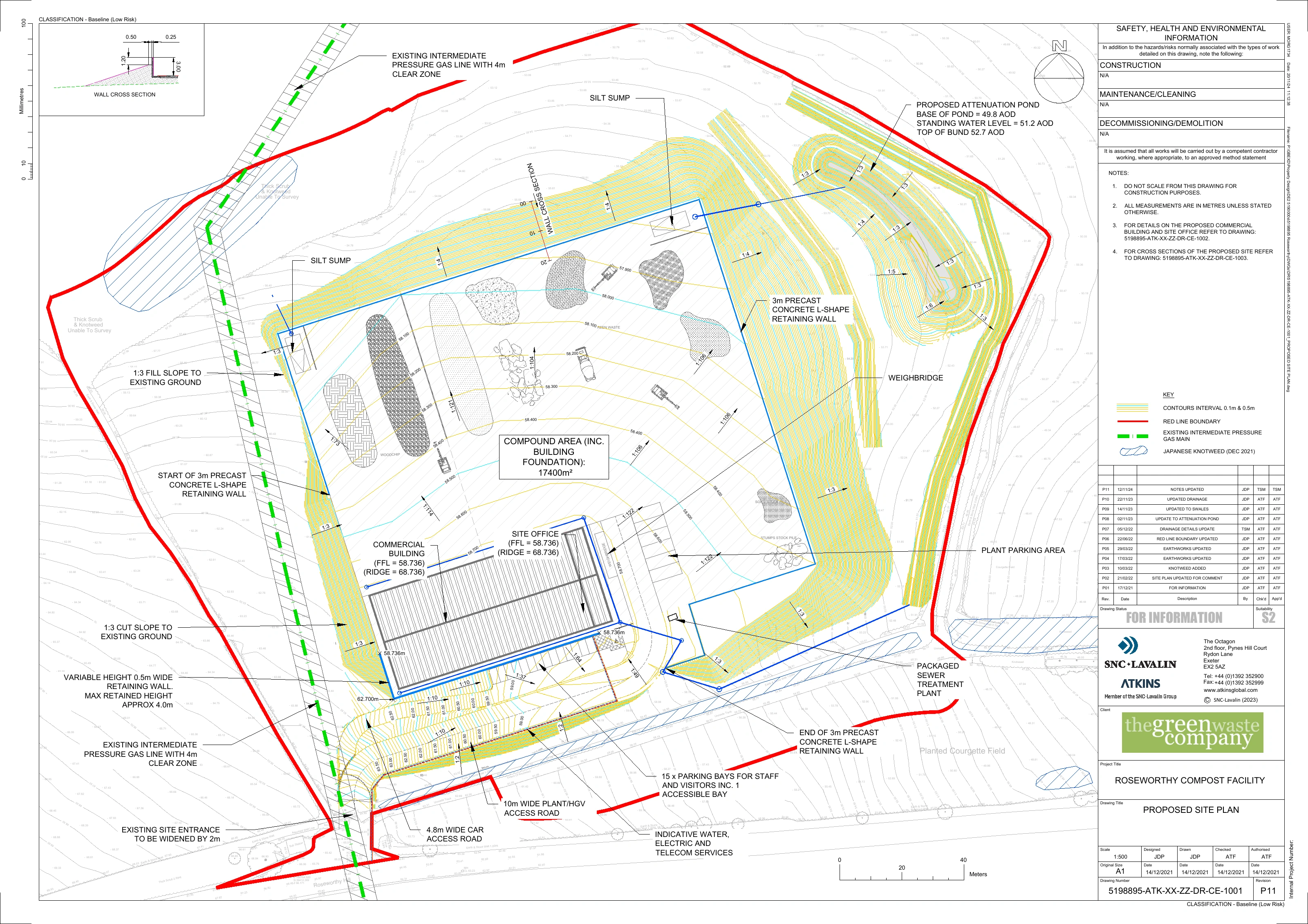

Application drawing / 01CE-1001 / P11
Atkins proposed site plan for the Roseworthy Compost Facility, showing the processing yard, building, attenuation pond, access and landscape earthworks.Explore full resolution

Operational layout

The working yard, building, weighbridge and separate access arrangements sit within the proposed earthworks and attenuation layout.

Atkins / November 2024 / Proposed design

Application drawings / November 2024. Engineering: Atkins. Original colours, title blocks and drawing references retained. These sheets record the proposed design.

The team

One strategy.
One team.
One point of contact.

STAGE led the whole application, managed the project and coordinated the professional team. It prepared the Planning, Design and Access Statement, bringing the client’s operational brief, site-selection case, design response and specialist conclusions into a single planning narrative.

Specialist consultants contributed the engineering, landscape, environmental and other technical evidence required for the application. STAGE brought that work together around one planning strategy and one point of contact for the client. The engineering drawings reproduced here are by Atkins.

Engineering / Project team

Atkins prepared the Roseworthy engineering drawings. These original marks are reproduced from the application drawing title blocks, retaining their SNC-Lavalin group wording.

  • Original SNC-Lavalin logo from the Roseworthy engineering drawing title block

    Group mark on the Roseworthy engineering drawings

  • Original ATKINS logo with Member of the SNC-Lavalin Group wording

    Engineering consultant / Roseworthy

Official AtkinsRéalis logo

AtkinsRéalis is the current corporate identity. The Atkins and SNC-Lavalin marks are retained above as they appear on the Roseworthy drawings.

Project leadership & planning / STAGE
STAGE ran the application, managed the whole project and coordinated the consultant team. Its Planning, Design and Access Statement connects the operational need, site, design and specialist evidence.
Engineering / Atkins

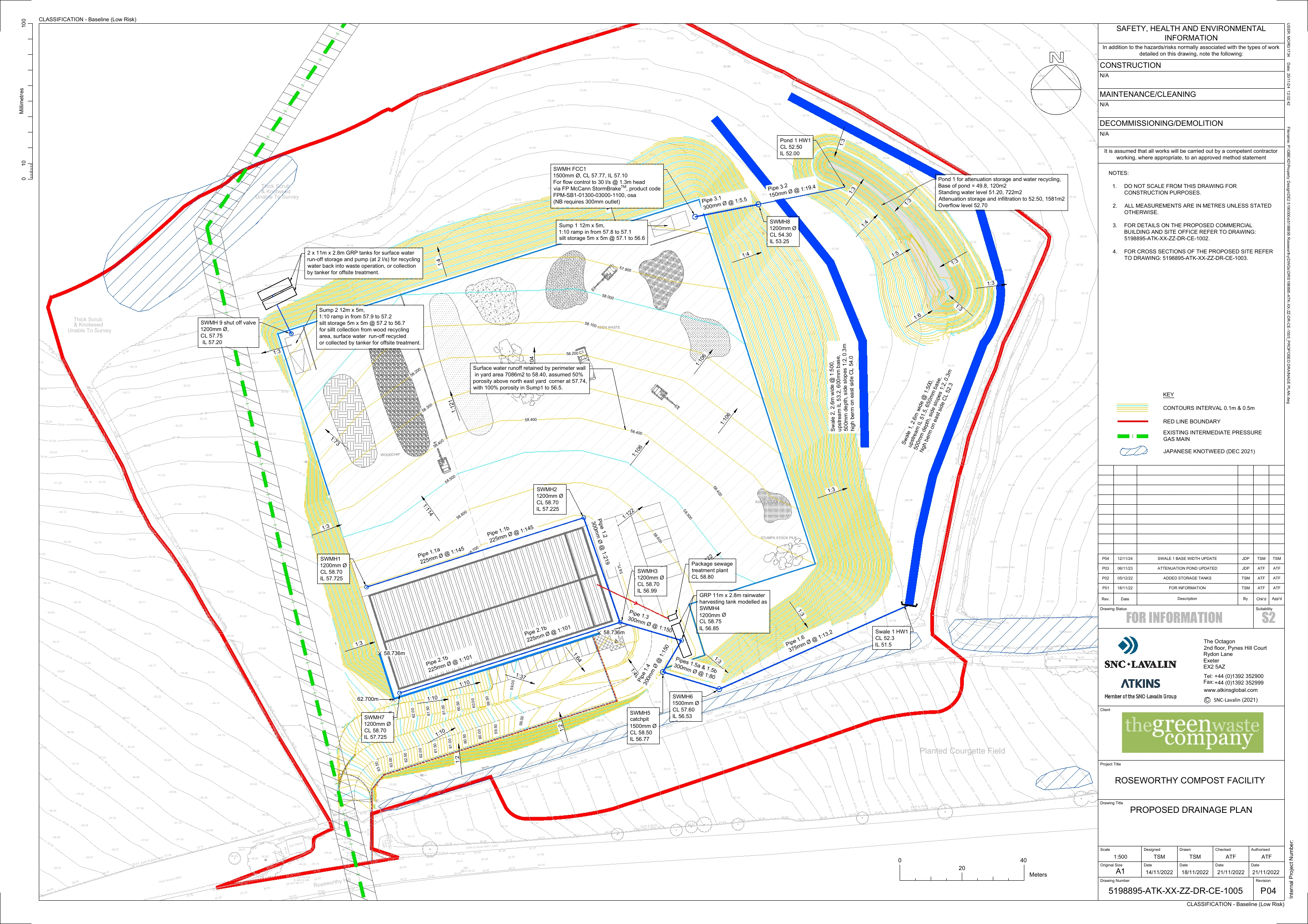

Site layout, levels, earthworks, drainage and pond sections form part of the coordinated engineering package. The statement also references Atkins technical and air-quality reporting.
Landscape & ecology / CEC
Cornwall Environmental Consultants’ work covers landscape and visual assessment, planting, ecology, biodiversity and Japanese knotweed management.
Specialist evidence
The statement references Anderson Midland on land classification, MOLA on geophysics, Hawk Heritage on heritage, Inacoustic on noise and Jon Pearson Associates on transport.

The outcome / Planning consent

Planning permission secured.

Permission granted

PA24/08685 / Roseworthy / Cornwall

Planning permission was granted for the Roseworthy recycling facility under application PA24/08685. STAGE led the whole application, managed the project and coordinated the consultant team, connecting the operational brief, design and specialist evidence through to consent.

  • Application leadership
  • Whole-project management
  • Consultant coordination

Documented output

An evidenced planning submission.

The November 2024 statement presents the planning case and schedules 27 supporting drawings, reports and community-engagement items. Together, they make the relationship between the operation, the design and the environmental evidence visible to the decision-maker.

STAGE brought the complete submission together and managed the application and professional team through to the planning decision.

The next stage

From permission to implementation.

The planning decision establishes a consented route for the Roseworthy facility. Conditions and implementation form the next chapter; those milestones will be added to the case study as they are confirmed.

For other operational sites, the same discipline matters: connect the business requirement, site layout and specialist evidence before a fragmented brief creates avoidable delay or redesign.
